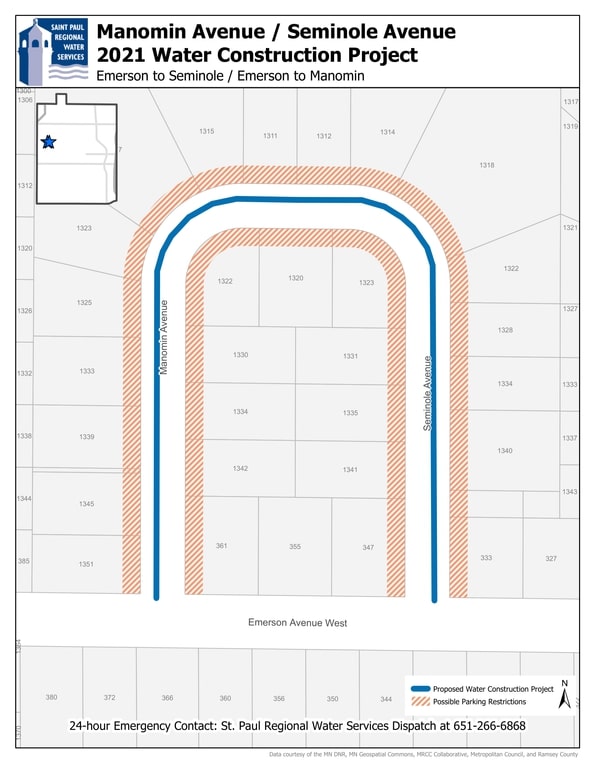

Seminole Manomin Main Rep

Project Engineer: Tom Jauquet 651-266-6271

The original cast iron water main within the project area was installed in 1956 and has experienced repeated main breaks over the years. To continue to ensure the reliability of our system, SPRWS regularly replaces aging infrastructure that may be susceptible to breaking with newer, more dependable infrastructure.

SPRWS will be replacing the existing 6" cast iron water main with 6" ductile iron pipe. A contractor will be hired to provide excavation and restoration of the roadway for the project.

Project Scope:

  • SPRWS to replace approximately 600 feet of 6" water main with new, 6" main
  • SPRWS to replace valves and hydrants
  • Contractor to excavate and restore street pavement, curb, and sidewalk as needed

Project Updates

Xcel gas is currently doing work in the project area. SPRWS start dates TBD.

Project Updates

Xcel is scheduled to finish their work in the area by May 21st.
SPRWS to begin setting up temporary water supply the week of May 24th.
Excavation and water main replacement scheduled to begin the week of June 3rd.

Project Updates

Temporary water main setup is in progress. Excavation and water main replacement to begin the week of June 7th.

Project Updates

Excavation and water main replacement work are in progress.
