Description
Work is beginning on residential streets in the Ivy-Birmingham area as part of the 2026 Residential Mill and Overlay Program. Streets will be resurfaced using a process called mill and overlay to provide a smoother roadway surface. Crews will remove the top layer of existing pavement and replace it with a new layer of bituminous (asphalt) pavement.

The project also includes pedestrian improvements at select locations. Curb ramps at intersections will be reconstructed to meet Americans with Disabilities Act (ADA) standards and improve accessibility for people walking and rolling.

Location
See map below - neighborhood streets between Arlington Avenue, Maryland Avenue, East Shore Drive, and Hazelwood Street

Timeline
2026

Tags

Resurfacing is Completed

  • Hazelwood – Maryland Ave to Sherwood St dead end
    • Milling – Completed Monday, October 5
    • Paving – Completed Tuesday, October 6
  • Ivy – Hazelwood St to Prosperity Ave
    • Milling – Completed Monday, October 5
    • Paving – Completed Wednesday, October 7
  • Sherwood – Hazelwood St to Prosperity Ave
    • Milling – Completed Monday, October 5
    • Paving – Completed Wednesday, October 7
  • Barclay – Maryland Ave to Arlington Ave
    • Milling – Completed Monday, October 5
    • Paving – Completed Thursday, October8
  • Winchell – Dead end to Arlington Ave
    • Milling – Completed Tuesday, October 6
    • Paving – Completed Thursday, October 8
  • Birmingham – Prosperity to Arlington Ave
    • Milling – Completed Tuesday, October 6
    • Paving – Completed Friday, October 9
  • Etna – Maryland Ave to Dead end
    • Milling – Completed Tuesday, October 6
    • Paving – Completed Friday, October 9
  • Ivy – Prosperity Ave to Clarence St
    • Milling – Completed Tuesday, October 6
    • Paving – Completed Tuesday, October 13
  • Clarence Ct – Maryland Ave to Dead end
    • Milling – Completed Wednesday, October 7
    • Paving – Completed Tuesday, October 13
  • Clarence – Maryland Ave to Arlington Ave
    • Milling – Completed Wednesday, October 7
    • Paving – Completed Wednesday, October 14
  • McAfee/Topic – Clarence St to Arlington
    • Milling – Completed Wednesday, October 7
    • Paving – Scheduled Wednesday, October 14

Project Updates

Project Map

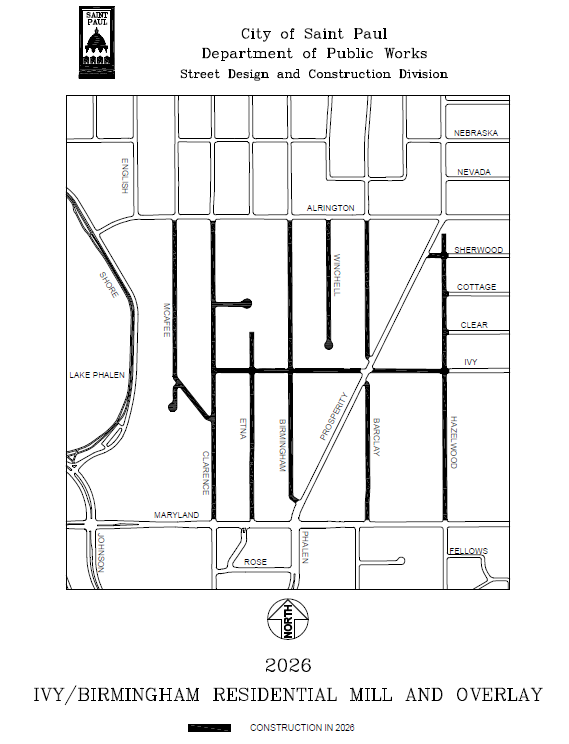

Map of the Ivy-Birmingham neighborhood showing streets scheduled for construction in 2026 highlighted in dark blue. A north arrow and legend are included.

Project Documents

Tree Removals and Replacements

The city works to minimize impacts to trees during construction whenever possible. While some street construction projects require tree removal or replacement, impacts to trees are expected to be minimal for this project.

Any planned tree removals will be completed by April 14, 2026, in accordance with endangered species habitat regulations. Trees identified for removal will be marked in advance with a red X on the trunk.

Additional tree removals may be necessary if unforeseen conditions are encountered during construction.
