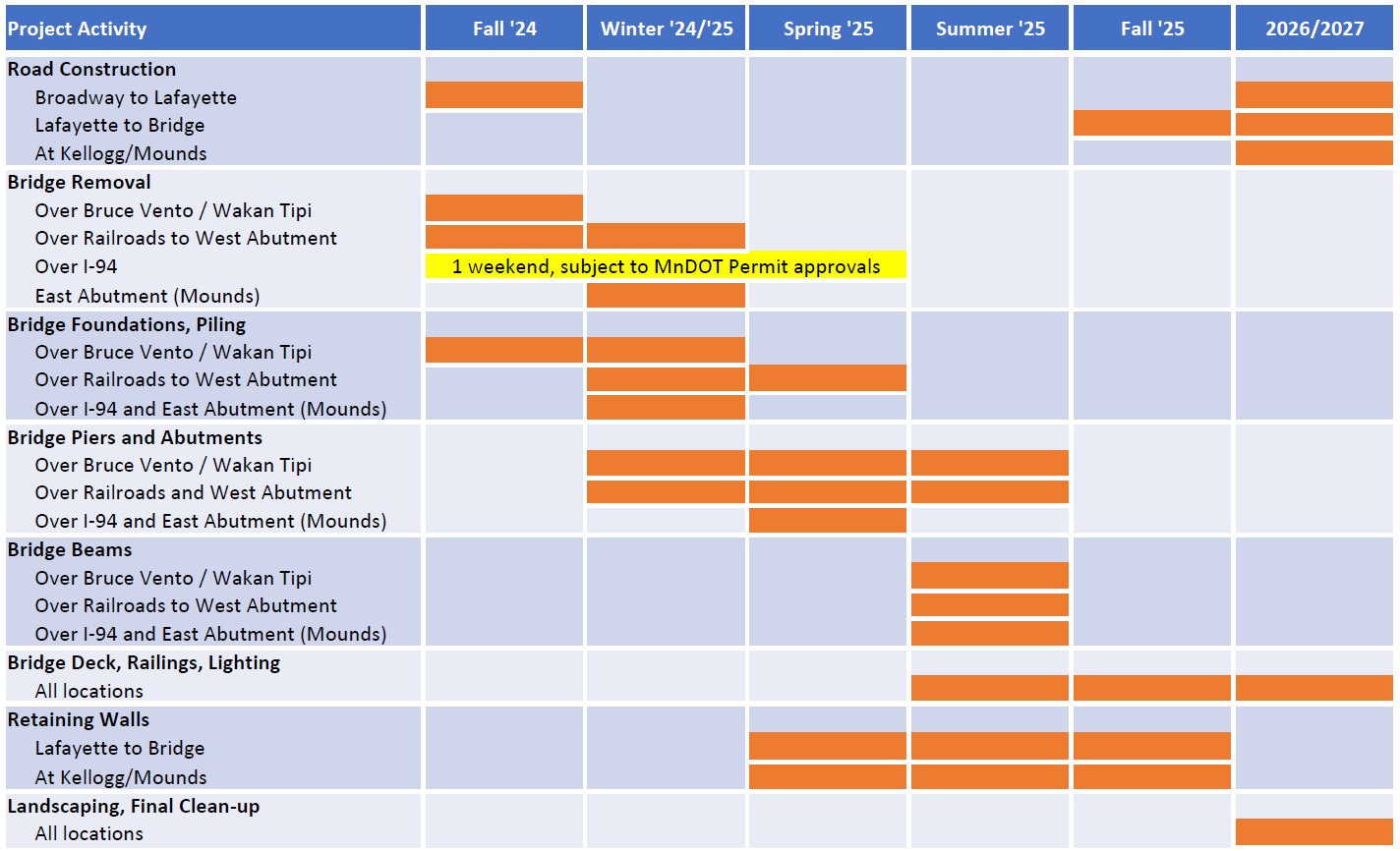

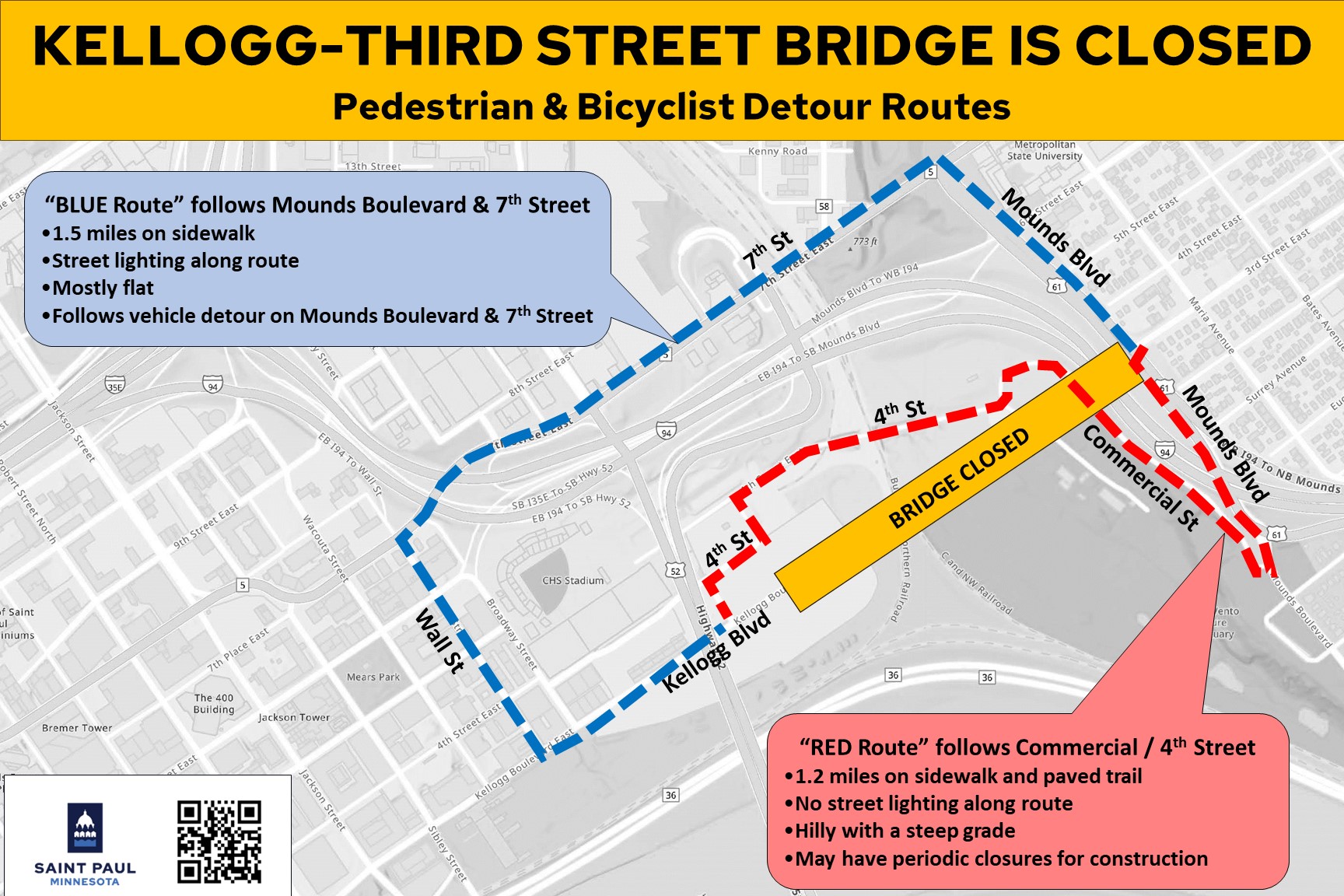

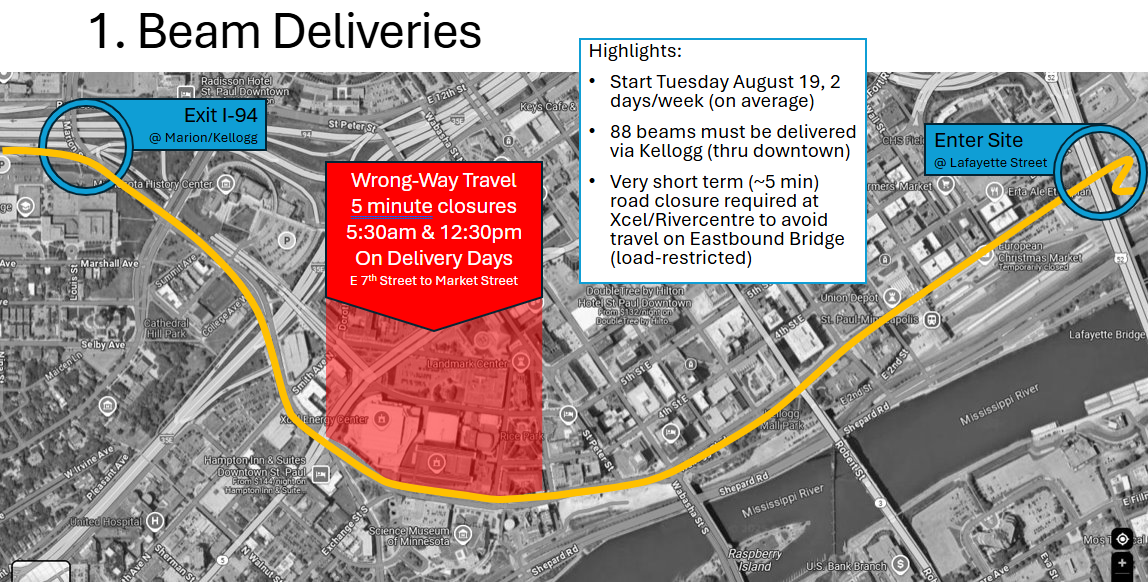

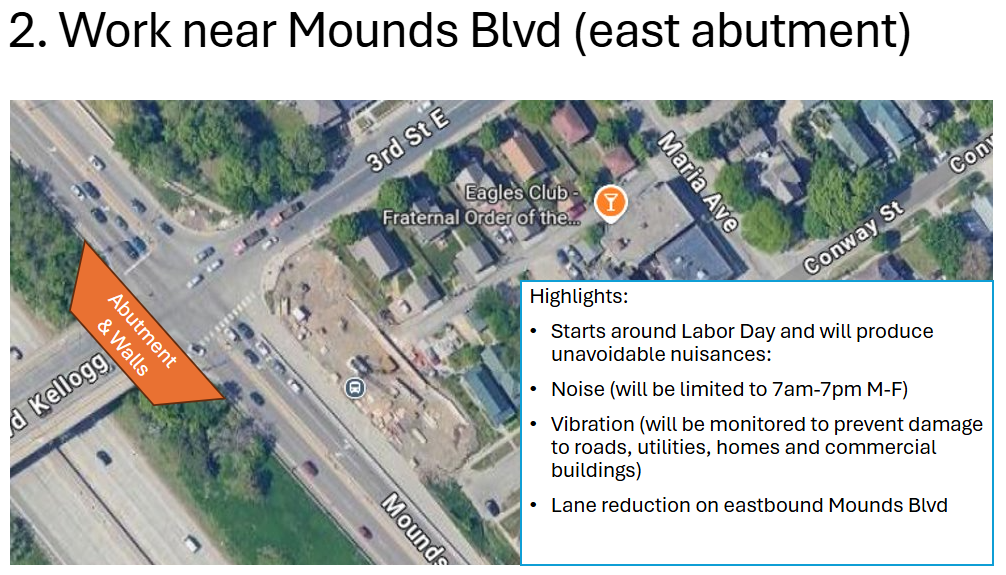

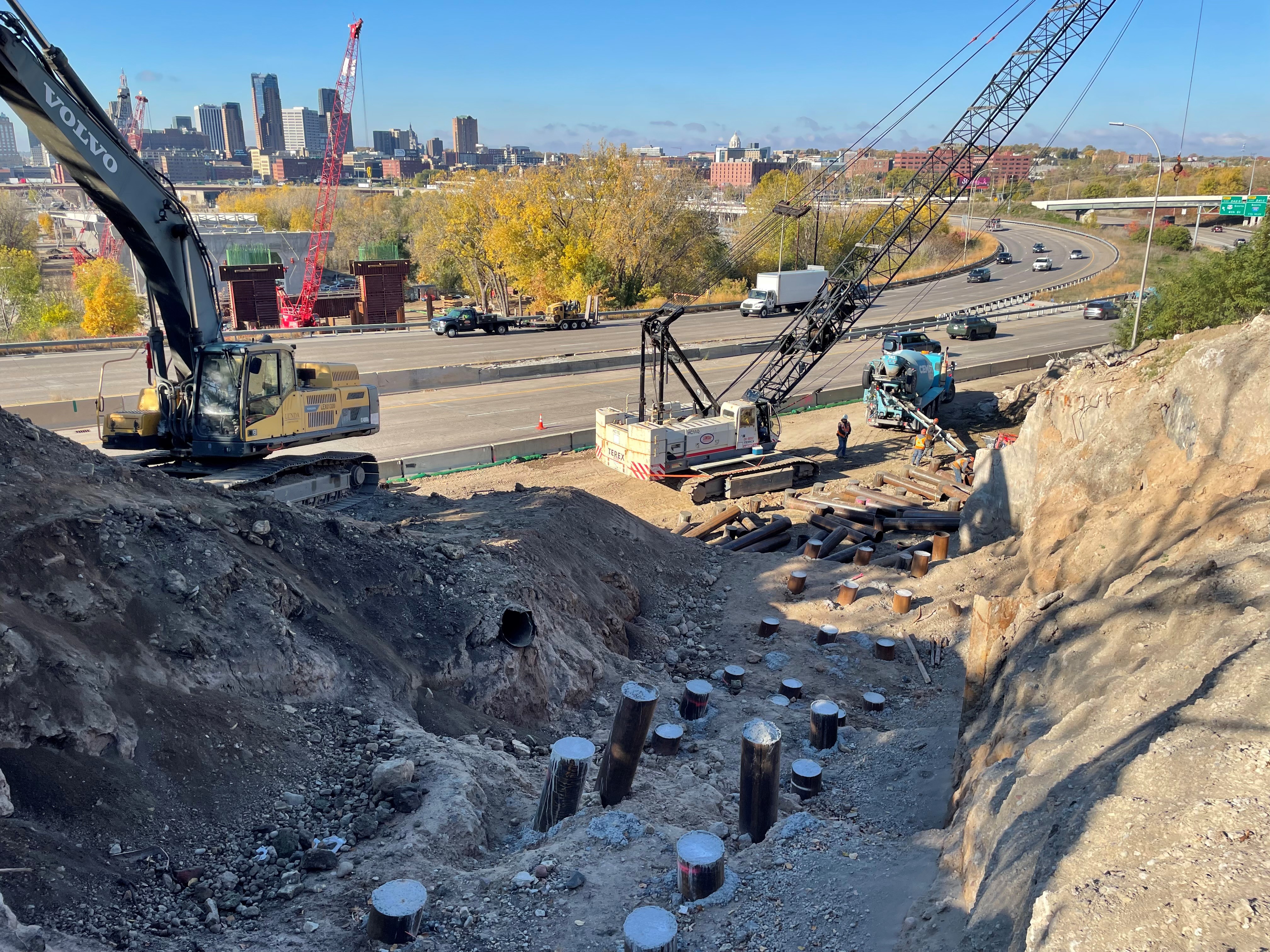

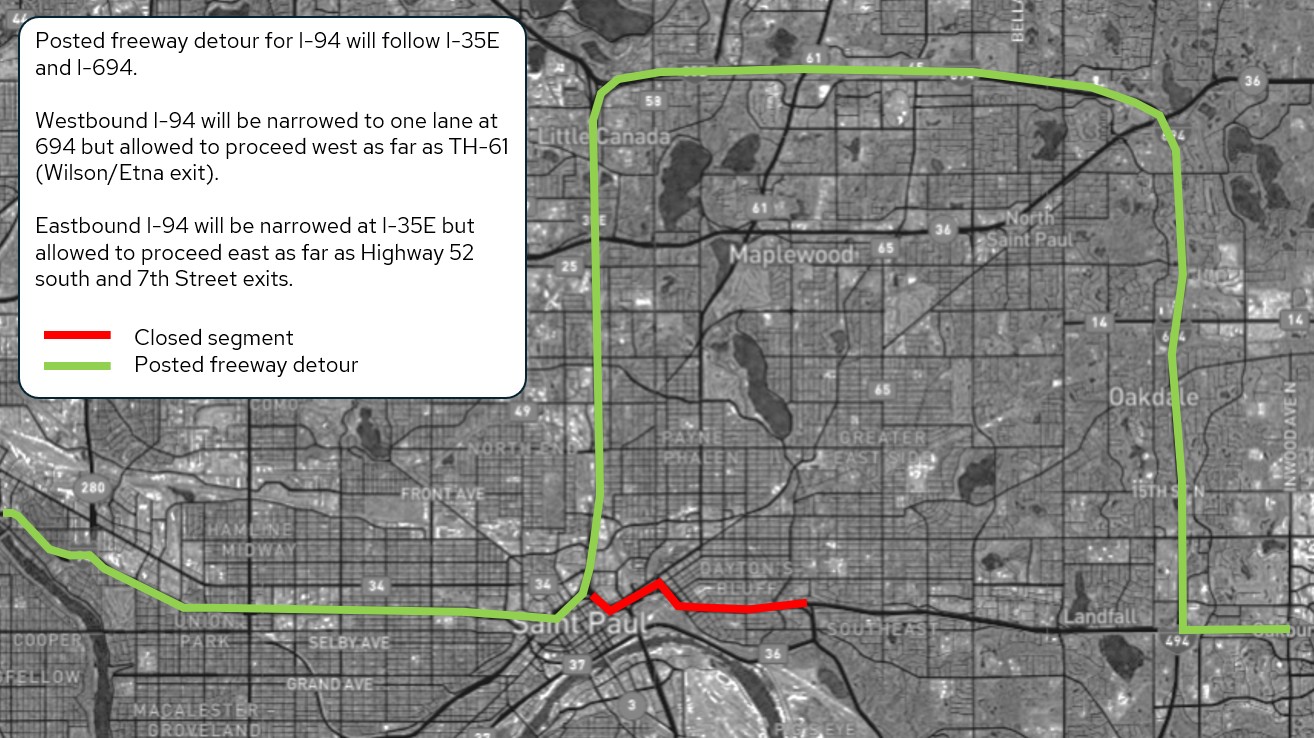

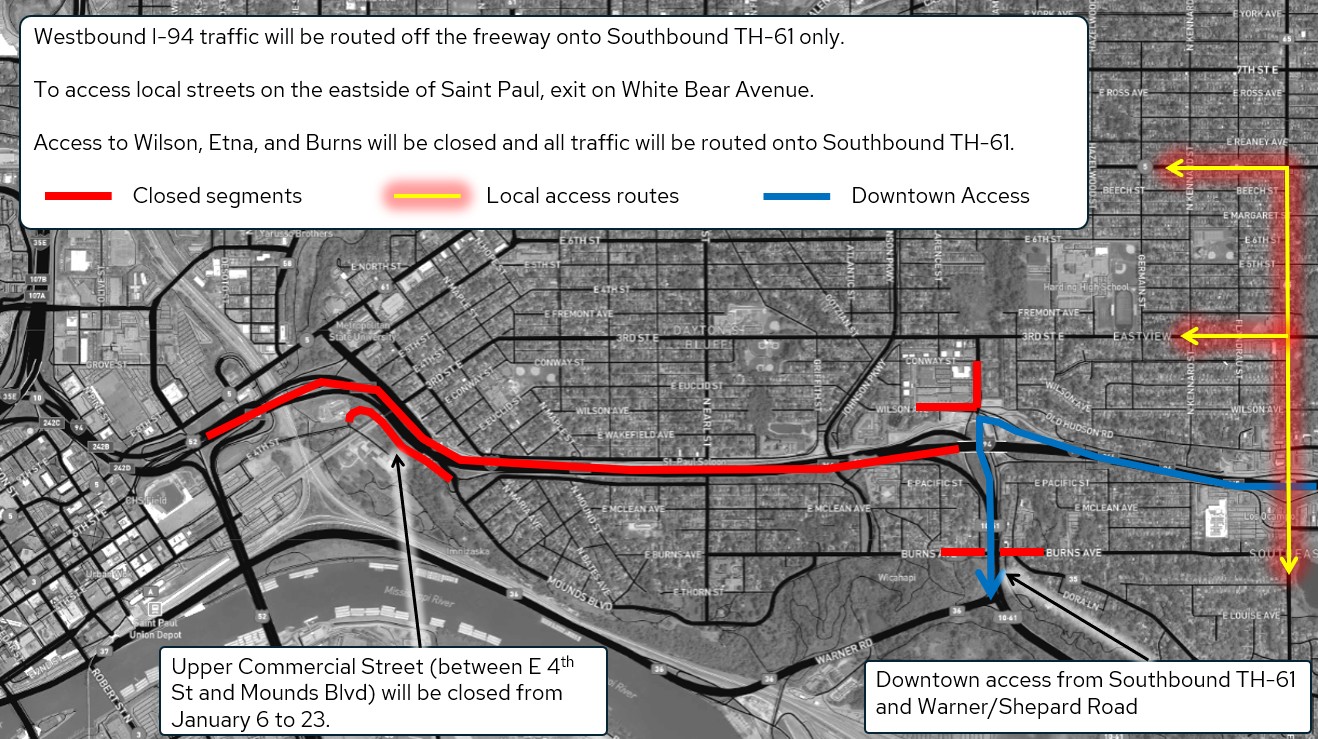

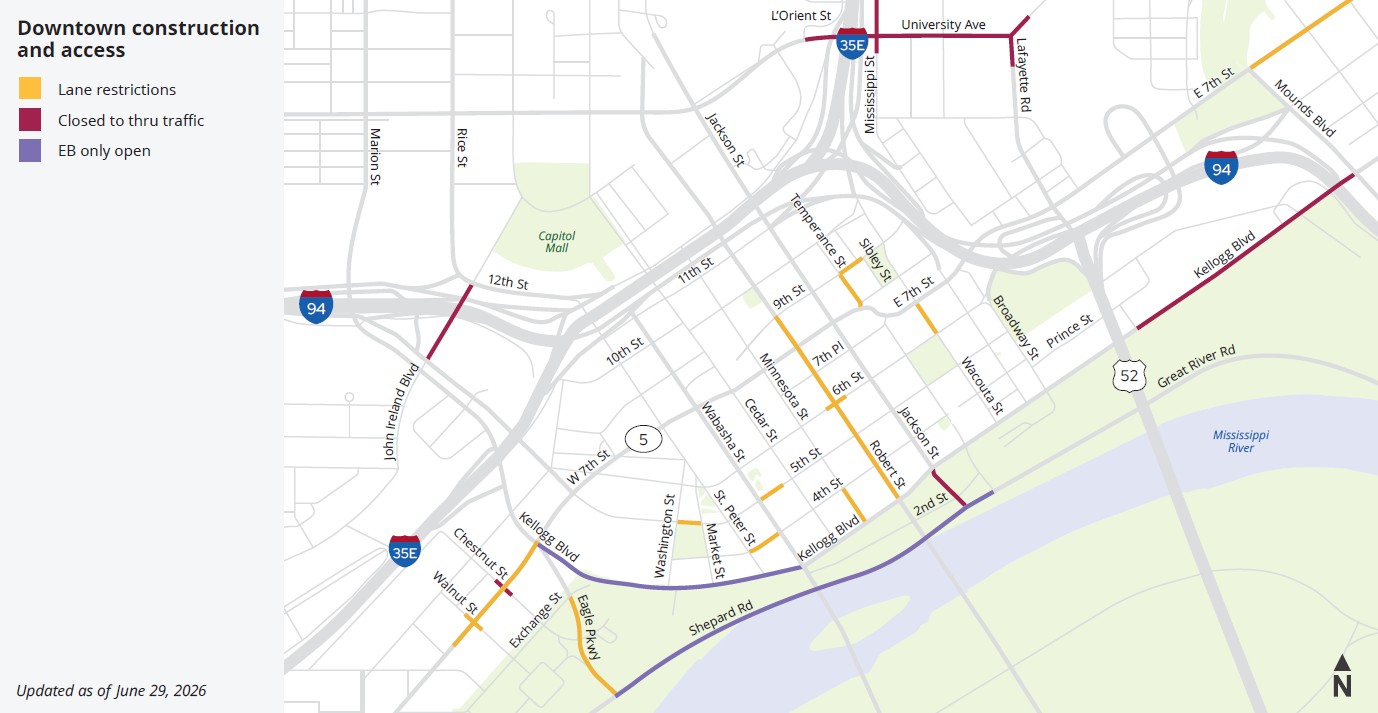

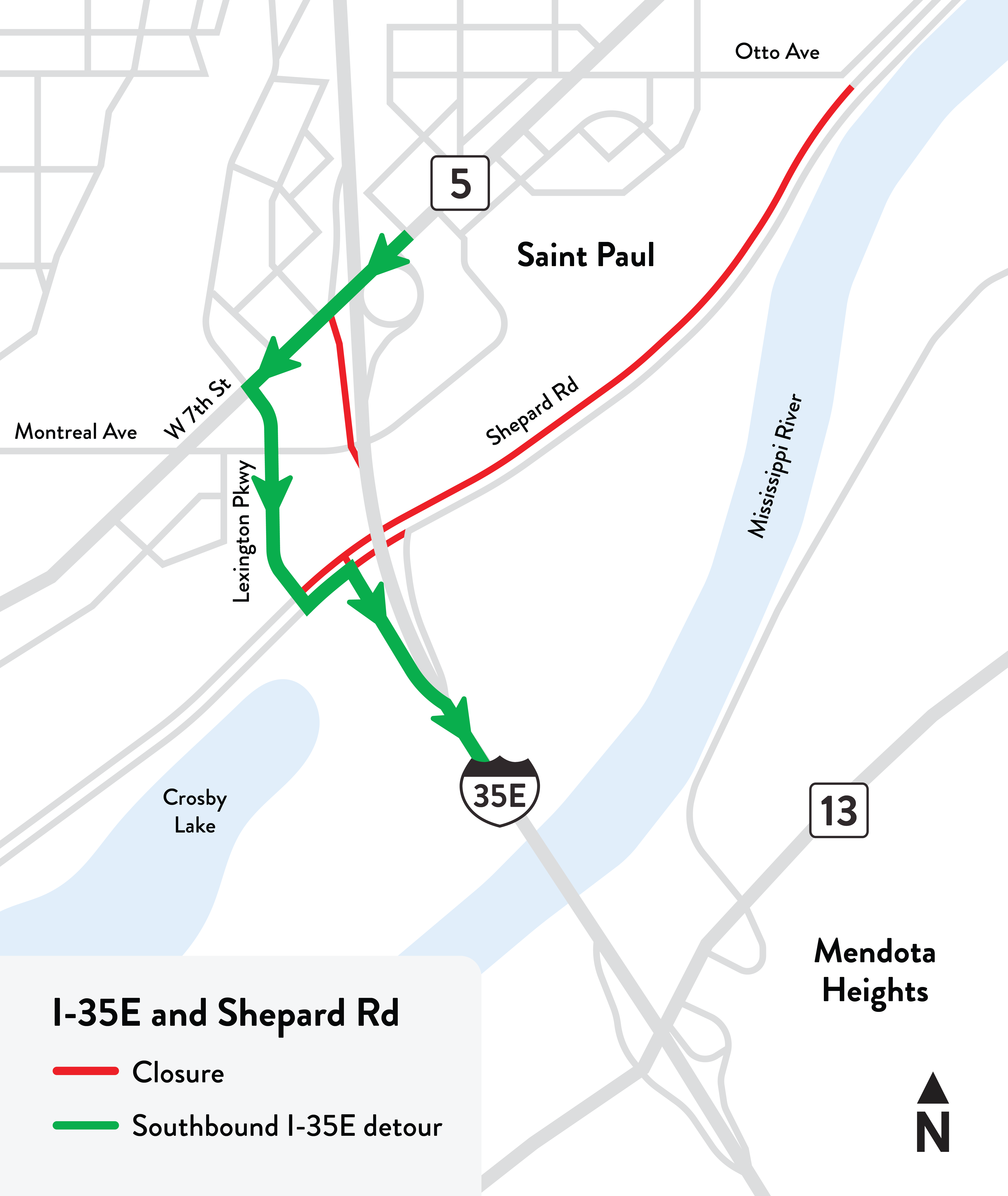

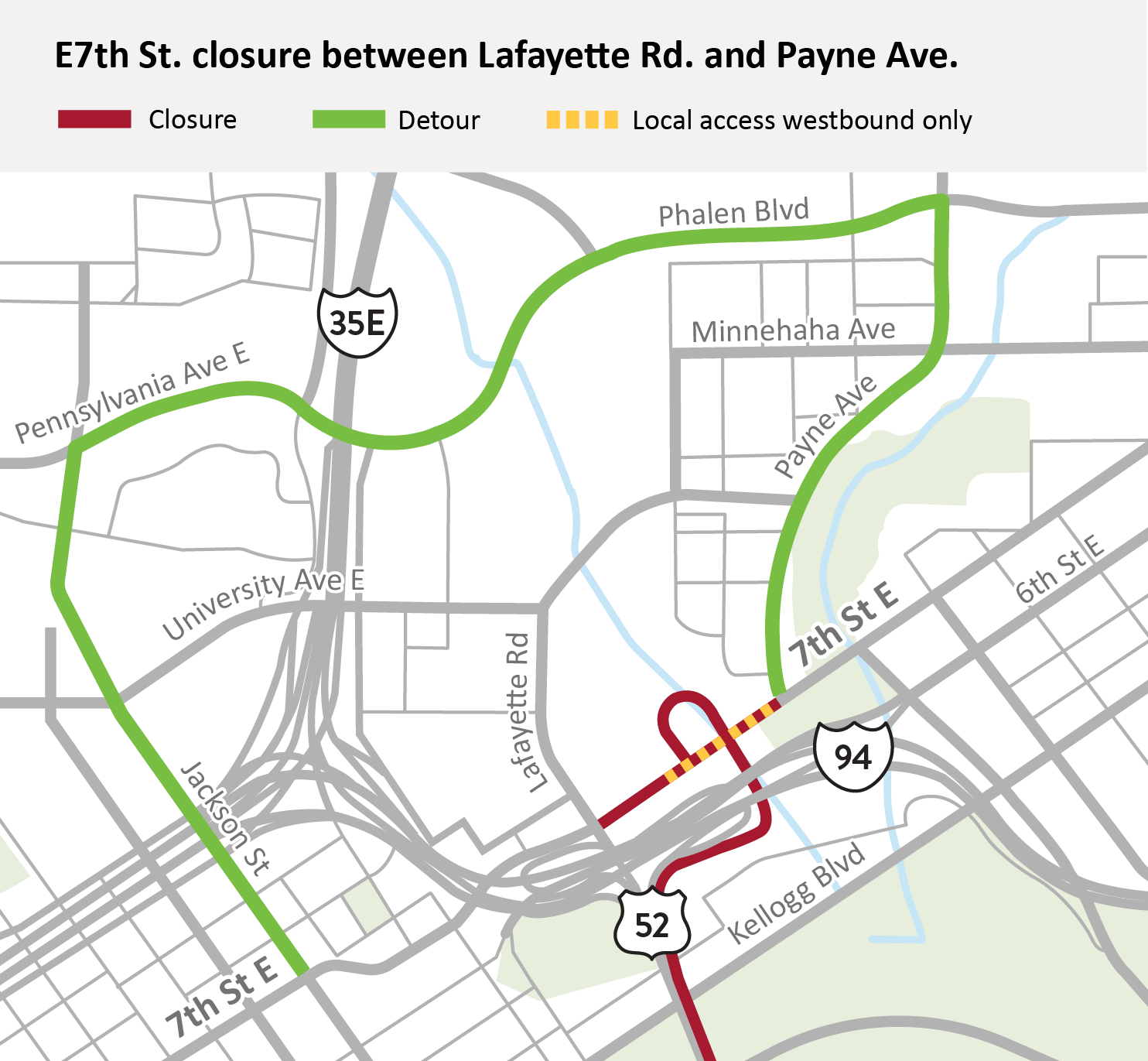

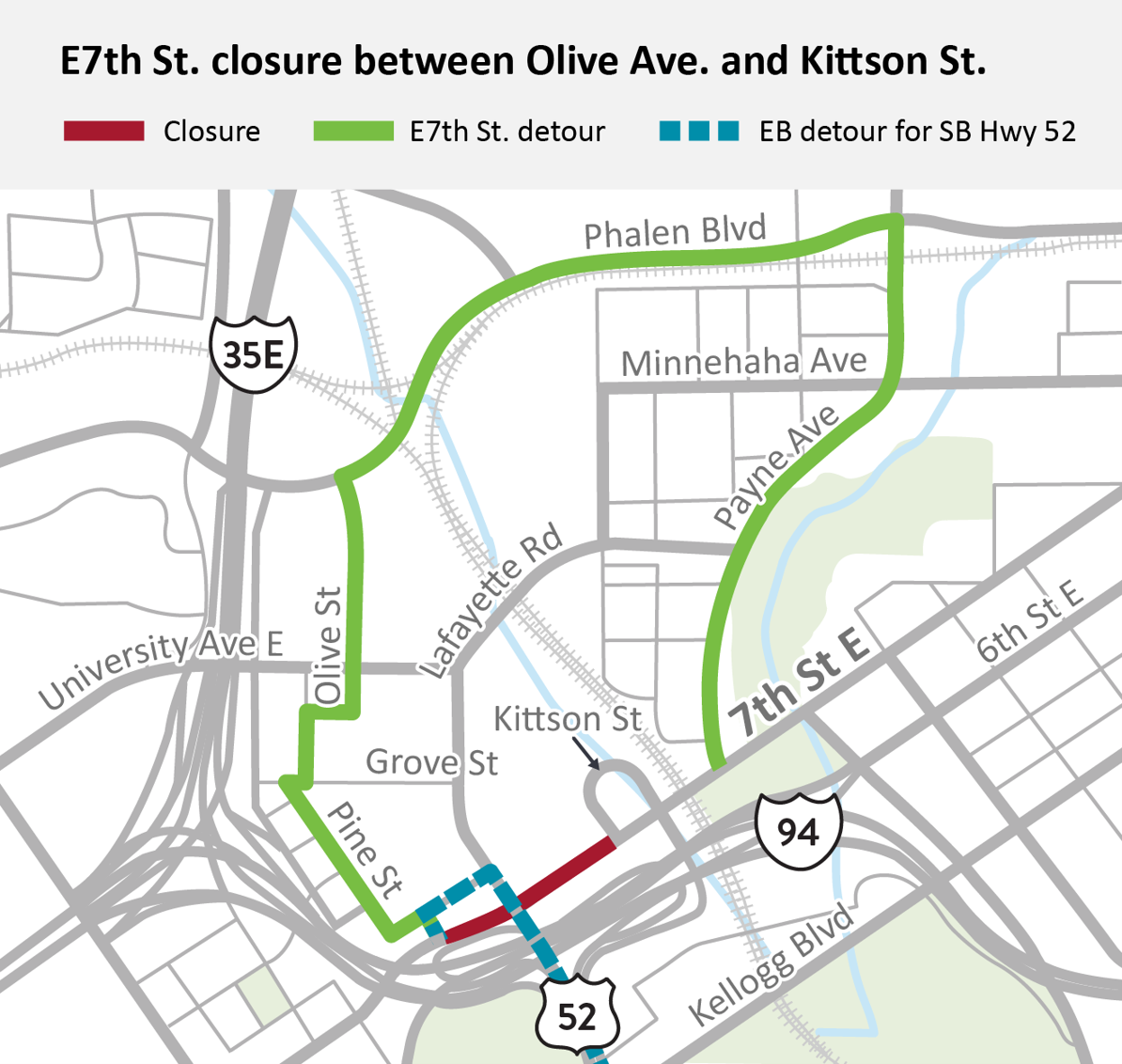

Project timeline has been updated in response to continued coordination with key stakeholders including railroads, utility companies, adjacent property owners, and Metro Transit's Gold Line Bus Rapid Transit project. Road closures and traffic detours will go into effect when bridge replacement work begins in early 2023. Kellogg Boulevard is expected to be re-opened to traffic in late 2025.
Numerous local, state, and privately-led projects will happen concurrently with bridge work. To best manage the bridge contract and mitigate local traffic impacts, City staff will continue to review the project timeline and make adjustments as needed.

A series of layouts showing final design features will be posted to the project webpage in Summer 2022. Construction updates will also be provided.
