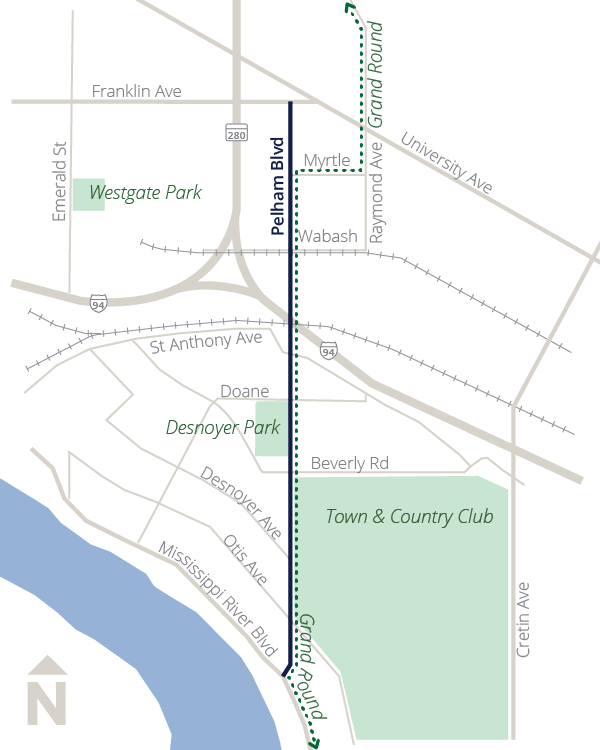

Graphic image showing the extents of the Pelham Blvd reconstruction and surrounding streets, parks, and Mississippi River.

Description
In 2026, the City of Saint Paul will be reconstructing Pelham Boulevard between Mississippi River Boulevard and Franklin Avenue. The project will replace underground utilities, as well as the sidewalks, street surface, curbs, lighting, and pedestrian ramps. An off-street bikeway at sidewalk level will be added to Pelham, and the flexible white posts currently in the street will be removed. The design is largely guided by the Grand Round Design and Implementation Plan (2017), and the Saint Paul Bicycle Plan (2024).

Location
Pelham Boulevard from Mississippi River Boulevard to Franklin Avenue

Timeline
Engagement in 2024 and 2025

Design 2025

Construction in 2026 - exact timeline will be shared once known

Tags

Pelham Boulevard Reconstruction Project Update: August 28, 2026

Please note: In order to streamline resident comments, concerns, and feedback, please send messages to publicworksinfo@ci.stpaul.mn.us or call 651-266-6100.

Traffic Impacts

  • Construction work hours are 7 a.m. - 7 p.m. daily. Workers may be on-site and working up until 7 p.m. on a given day. Weekend work may also occur through the remaining construction season.
  • Intermittent closures of St Anthony Avenue and Doane Avenue will occur when sewer and water work is occurring. Closures will not occur simultaneously.
  • Pelham Boulvevard is still closed.
  • Mississippi River Boulevard is closed and is being used for trucking materials in and out, so please be mindful when in the area.
  • Current detour is on Franklin Avenue, University Avenue, Vandalia Street/Cretin Avenue, and Marshall Avenue.
  • Homes on Pelham Boulevard between Beverly Road and Otis Avenue will continue to have access but expect disruption and exercise caution when navigating active site.
  • Parking will not be allowed within the construction area.
  • Bike, pedestrian, and driver detours are posted according to the above detour routes. These may change throughout the project and signs will be adjusted. Printable maps are available at stpaul.gov/pelham

    • Pedestrians and cyclists are to follow detours posted at St Anthony Avenue and Mississippi River Boulevard as Pelham Boulevard is CLOSED to all cyclists, pedestrians, and vehicles.

This Week (August 24 - 28)

  • Sanitary sewer work was completed through the Intersection of Doane Avenue and from I-94 to Wabash Avenue.
    • Remaining sanitary service repairs will be completed early next week.
  • Water main installation from Beverly Road to Doane Avenue was completed through the intersection of Doane Avenue.
  • The road has been graded out from Mississippi River Boulevard to Otis Avenue and from Otis Avenue to Beverly Road.
    • There is a section that still needs to be graded between Otis Avenue and Beverly Road following storm sewer work, which will happen early next week.
  • Sidewalk placement has begun on the east side of Pelham Boulevard between Mississippi River Boulevard and Beverly Road. Boulevard restoration has started where applicable, adjacent to the sidewalk.

Next Week (August 31 - September 4)

  • Storm sewer work between Beverly Road and Doane Avenue will begin.
  • Sanitary service repairs and some sanitary manhole replacements will be done between Doane Avenue and St Anthony Avenue.
  • Water main installation up to St Anthony Avenue will be completed.
  • Curb and gutter will be placed from Mississippi River Boulevard to Desnoyer Avenue in the early part of the week.
  • Some sewer work will tentatively begin between Wabash Avenue to Myrtle Street.

Construction Communications

  • In order to streamline resident comments, concerns, and feedback, please send messages to publicworksinfo@ci.stpaul.mn.us.
  • Project contact is Tom Higbee 651-356-1569 for any day-to-day, on-site concerns.
  • Updates will be provided weekly on Friday to inform you of progress and expectation for following week.
  • Since June 24, project staff continue to host in-person, weather-permitting meetings at Desnoyer Park on Wednesdays from 3:00 p.m. to 4:00 p.m. Attendance is not mandatory and project staff will continue to answer questions via phone or email throughout the duration of construction.
  • Vibration Monitoring

    • On Friday, August 21, Saint Paul Public Works had three vibration monitoring devices installed along the project corridor.
      • The reconstruction work happening on Pelham Boulevard aligns with typical construction activities across the city.
      • Vibration monitoring is not a standard part of most construction projects; however, the city is adding monitoring due to some resident concerns.

All construction activities and traffic impacts are weather and schedule permitting and subject to change.

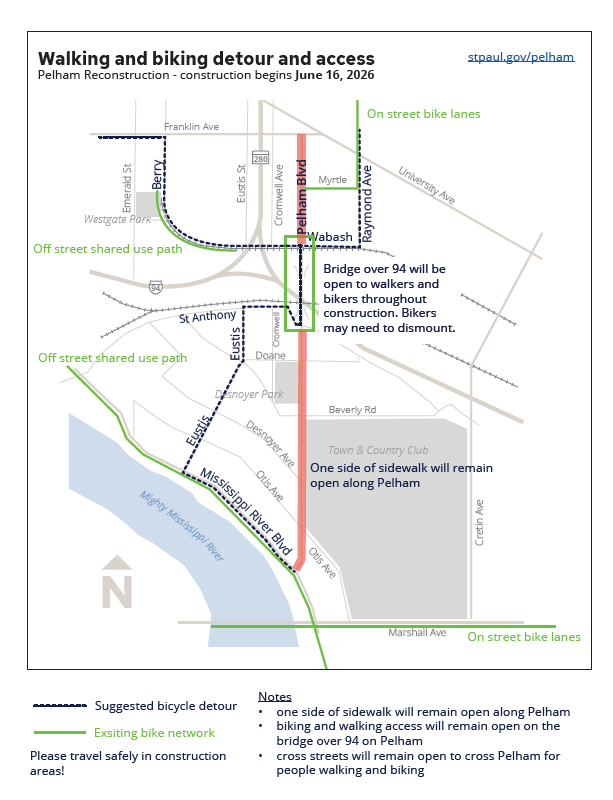

Pelham Boulevard Bike and Pedestrian Detour

Pelham Boulevard Driving Detour

Pelham Boulevard Construction Information Letter

Final Design Layout for Pelham Boulevard

The final design for Pelham Boulevard is complete. This layout consists of a legend, cross sections, and two stacked plan views, representing the length of the project. Design elements such as pavement, sidewalk, trail (bikeway), driveways, and tree impacts have also been identified. Project staff have put together a detailed memo that outlines each design element and tree impacts.

Pelham Boulevard Final Design - March 2026

Memo for Pelham Boulevard Final Design - March 2026

Project Schedule

  • COMPLETED Summer and Fall 2024: Phase 1 community engagement. City staff will meet with the neighborhood about the project and timing. Community members can share their goals for the project.
  • COMPLETED Winter 2024 to 2025: Initial designs for Pelham. City staff will consider the feedback from engagement, as well as current city policies and goals, and come up with a recommended design option for Pelham.
  • COMPLETED Summer 2025: Phase 2 community engagement. City staff will share the recommended design option with the community and get feedback. Tweaks can be made to the design option based on feedback from Phase 2.
  • Fall and Winter 2025 to Winter 2026: Detailed design. Once the recommended design option has been decided, city engineering and planning staff will work on the details of the design. Updates will be shared with the community along the way to make sure the design is consistent with community expectations. Designs are being finalized currently. After designs are completed, the project will be put out to bid and a contractor will be hired.
  • WE ARE HERE Spring thru Fall 2026: Construction. The reconstruction of Pelham will take most of spring, summer, and fall. City staff will provide regular updates to the community about construction impacts, detours, and progress.

Previous Planning

The reconstruction of Pelham Boulevard is guided by adopted and approved city plans.

  • The City of Saint Paul Bicycle Plan (April 2024) recommends a separated bikeway for Pelham Boulevard (see the Planned Bicycle Network map on page 9).
  • Pelham Boulevard is part of the Saint Paul Grand Round, a network of separated bikeways circling the city and connecting parks and open space. Page 66 of the Grand Round Design and Implementation Plan (2017) shows the proposed design for Pelham Boulevard.
    • The Grand Round Design and Implementation Plan (2017) sets the vision for what the street looks like above ground, and the reconstruction of Pelham Blvd is following this vision. Aging infrastructure is the reason the reconstruction is happening now. A reconstruction provides the opportunity to upgrade other infrastructure not specifically discussed in the Grand Round Design and Implementation Plan, like underground utilities and the street itself. Reconstructions of streets happen infrequently, and it is important the city address needs along the corridor – both above and below ground.  

Project Updates

FAQ

Public Hearing on January 28

The City of Saint Paul held a public hearing for the Pelham Boulevard reconstruction project during the City Council meeting on Wednesday, January 28, 2026.

Property owners, tenants, and others were invited to attend the hearing to provide comments. If you were unable to attend the meeting, you can watch a recording of the public hearing from January 28. A sample notice mailing is included in the Project Documents section below.

For more information about the assessment, or to see if you are being assessed, please call 651-266-8858 with the parcel ID/address listed in your letter. All property owners were mailed a notification letter with the hearing information and the estimated assessment details from the Office of Financial Services.

More information about special assessments, including how the special assessment is calculated, is available at stpaul.gov/specialassessments

Investing in Saint Paul Streets: Common Cent

A portion of this street reconstruction project will be paid for by a 1% local option sales tax, called Common Cent. This sales tax was approved by Saint Paul voters in November 2023. A portion of the project will also be funded through assessments to property owners adjacent to the project. The estimated assessment rate is based on a third-party special benefit analysis of the property values in the project area. Property owners will receive a notice of the estimated rate and date for a public hearing when estimated rates are available. More information on assessments can be found at www.stpaul.gov/specialassessments.

Project Documents

Note that construction information and materials are updated throughout the project. Please refer to the most recent version of maps and documents.
