Project Details
Description
Case Van Dyke is a Lead Free SPRWS project. Lead Free SPRWS is a 10 year plan to replace all lead water service lines in the SPRWS service area at no cost to property owners.
Lead service lines were primarily installed in the City of St. Paul from late 1880’s to the late 1920’s. For 25 years Saint Paul Regional Water Services (SPRWS) has been replacing lead water service lines within the street right-of-way to reduce the possibility of lead exposure.
Private Lead Service Line Replacements: Customers in this project area who have a private lead service line are eligible to have it replaced at no cost as part of the new Lead Free SPRWS program. You should have received a letter with instructions on next steps if you qualify. To learn more visit our Lead Free SPRWS page.
Location
One area:
- Streets bounded by White Bear Ave (west), Stillwater Ave (south), Hazel Street (east), & Magnolia Ave (north)

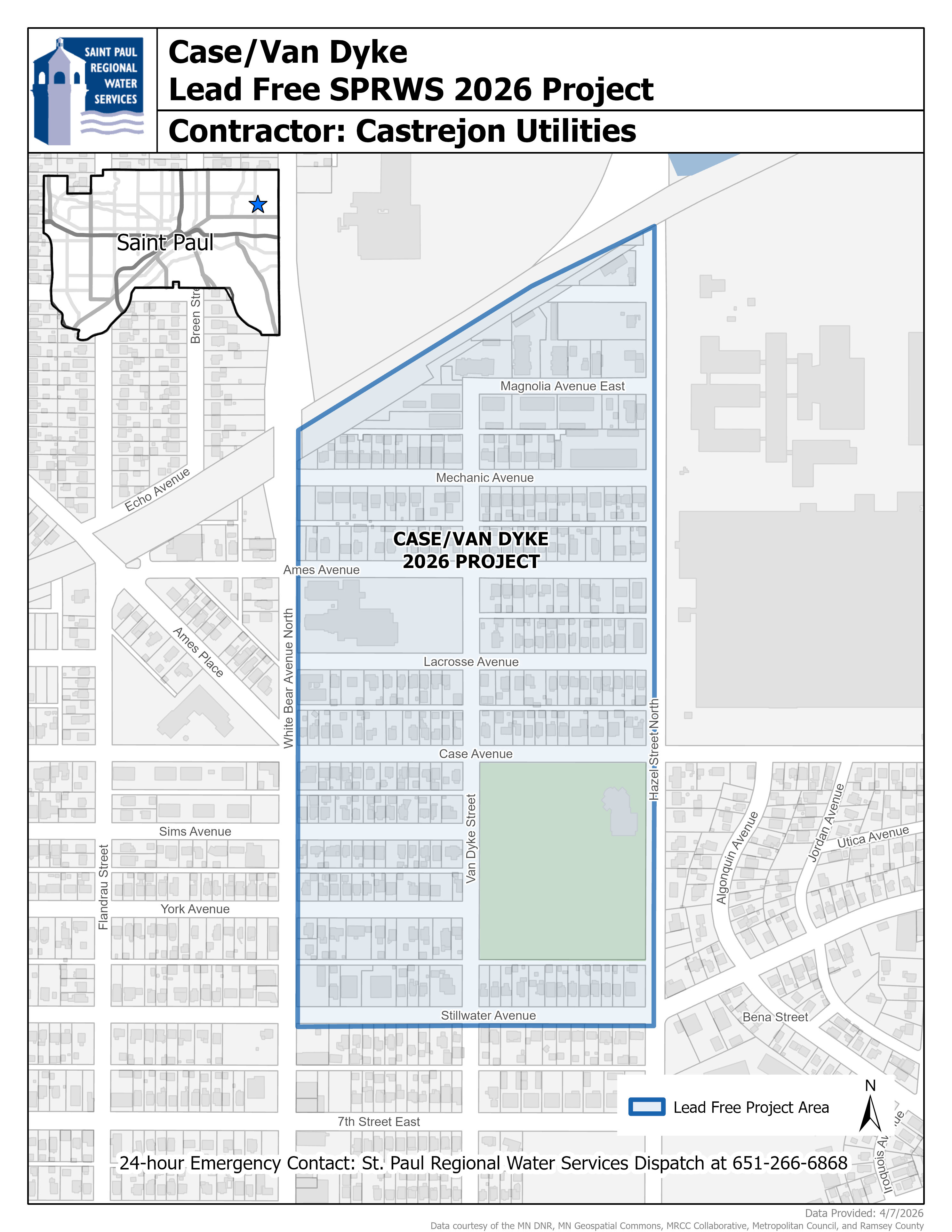

Refer to project map below for details.
Timeline
2026 Construction Season
- October 5 Update: 62 lead service line replacements complete
- Project is completed, restoration to happen over the next few weeks. No more lead replacements planned in this project area.
- September 28 Update: 50 lead service line replacements completed
- Crews currently working on:
- Lacrosse Ave between Van Dyke St and Hazel St N
- Case Ave E between White Bear Ave N and Van Dyke St
- Sims Ave between White Bear Ave N and Van Dyke St
- York Ave between White Bear Ave N and Van Dyke St
- Stillwater Ave E between White Bear Ave N and Van Dyke St
- Partial road closures:
- Lacrosse Ave between White Bear Ave N and Hazel St N, scheduled to open October 5
- Case Ave E between White Bear Ave N and Van Dyke St, scheduled to open October 5
- Sims Ave between White Bear Ave N and Van Dyke St, scheduled to open October 5
- York Ave between White Bear Ave N and Van Dyke St, scheduled to open October 5
- Stillwater Ave E between White Bear Ave N and Van Dyke St, scheduled to open October 5
- Roads will be closed during construction with local access
- Crews currently working on:
- September 21 Update: 31 lead service line replacements completed
- Crews currently working on:
- Lacrosse Ave between Van Dyke St and Hazel St N
- Case Ave E between White Bear Ave N and Van Dyke St
- Sims Ave between White Bear Ave N and Van Dyke St
- York Ave between White Bear Ave N and Van Dyke St
- Stillwater Ave E between White Bear Ave N and Van Dyke St
- Partial road closures:
- Lacrosse Ave between White Bear Ave N and Hazel St N, scheduled to open September 28
- Case Ave E between White Bear Ave N and Van Dyke St, scheduled to open September 28
- Sims Ave between White Bear Ave N and Van Dyke St, scheduled to open September 28
- York Ave between White Bear Ave N and Van Dyke St, scheduled to open October 2
- Stillwater Ave E between White Bear Ave N and Van Dyke St, scheduled to open October 2
- Roads will be closed during construction with local access
- Crews currently working on:
- September 14 Update: 16 lead service line replacements completed
- Crews currently working on:
- Lacrosse Ave between Van Dyke St and Hazel St N
- Case Ave E between White Bear Ave N and Van Dyke St
- Sims Ave between White Bear Ave N and Van Dyke St
- Partial road closures:
- Lacrosse Ave between White Bear Ave N and Hazel St N, scheduled to open September 16
- Case Ave E between White Bear Ave N and Van Dyke St, scheduled to open September 21
- Sims Ave between White Bear Ave N and Van Dyke St, scheduled to open September 21
- Roads will be closed during construction with local access
- Crews currently working on:
- September 10 Update: 9 lead service line replacements completed
- September 8 Update: 0 lead service line replacements completed
- Crews currently working on:
- Ames Ave between White Bear Ave N and Hazel St N
- Lacrosse Ave between White Bear Ave N and Hazel St N
- Partial road closures:
- Ames Ave between White Bear Ave N and Hazel St N, scheduled to open September 15
- Lacrosse Ave between White Bear Ave N and Hazel St N, scheduled to open September 15
- Roads will be closed during construction with local access
- Crews currently working on:
- August 3 Update: Work on track to begin late September/early October
- June 11 Update: Work scheduled to begin early October
Replacements
This project will replace approximately 73 lead water service lines.
