Project Details

Description

SPRWS is committed to maintaining a reliable and efficient water system for our community. To extend the life of our existing infrastructure and prevent disruptions, we perform ‘cleaning and lining’ projects on aging water mains. These projects involve the cleaning and lining of existing cast iron water mains, a process that effectively refurbishes pipes from the inside, reducing leaks and improving water quality without the need for full replacement.

The scope of this project includes:

  • Cleaning and lining of approximately 2,650 feet of cast iron water main to prevent corrosion and enhance water quality.
  • Installation or replacement of valves and hydrants to enhance water flow and accessibility for emergency services.
  • Repair and restoration of affected street pavement, curbs, and sidewalks to ensure public safety and accessibility.

Location

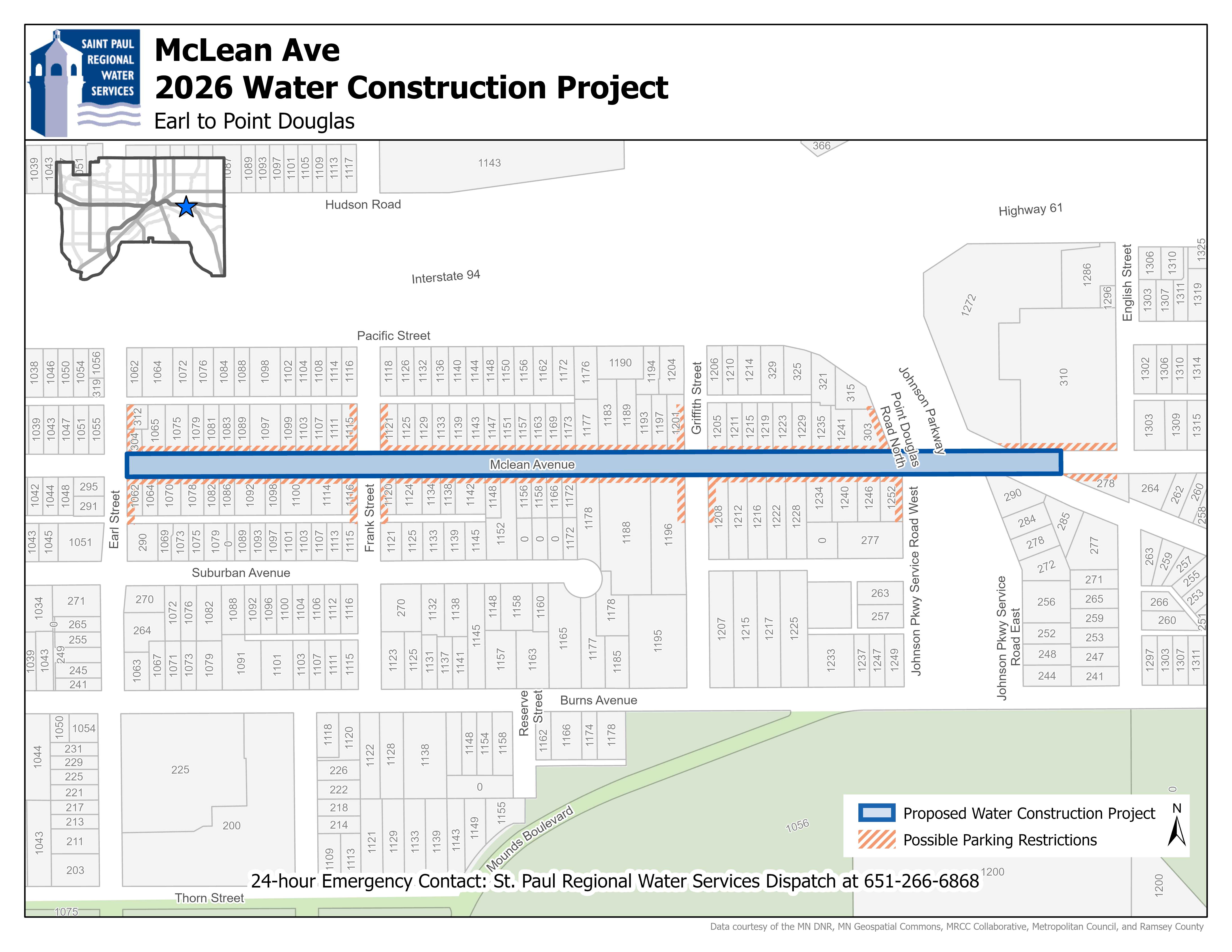

McLean Avenue from Earl to Johnson Parkway

Timeline

  • October 21 Update: Limited access traffic patterns remain in place. Watermain cleaning and lining expected to be complete October 23. Watermain testing to follow with an expected completion date of November 6.
  • October 8 Update: Limited access traffic patterns are in place with watermain cleaning set to begin October 10. Lining work expected to follow. Expected completion date is November 6.
  • October 1 Update: Temporary water installations complete. Cleaning set to begin week of October 5.
  • September 29 Update: Temporary water install in progress. Limited access traffic patterns are in effect with lining work underway. Expected completion date is set for October 30.
  • September 3 Update: Temporary water and pit excavations in progress.
  • August 28 Update: Temporary water install beginning August 31.
  • August 21 Update: Temporary water install beginning August 24.
  • August 11 Update: Temporary water installed. Limited access traffic patterns on beginning August 17 with watermain rehab work to follow.
  • July 30 Update: Temporary water install scheduled to begin August 10. Water main rehab work to follow.
    • Limited access traffic patterns scheduled to impact public starting August 17.
